Berford Street Reconstruction - Phase II
In 2019, the Town of South Bruce Peninsula retained R.J. Burnside & Associates Limited to provide detailed engineering design, project management, and construction administration services for the future replacement of watermain, sanitary sewer, storm sewer, and the required road reconstruction of several roads in the Wiarton settlement area.
Berford Street Reconstruction - Phase I
Phase I of the Berford Street reconstruction - Division Street south to George Street - was completed between 2019 and 2023. This phase included the design and reconstruction of underground infrastructure, and the roadway, forming a key first step in overall improvements.
Current Project Phase
Funding has been allocated in the Town's 2025 and 2026 Capital Budgets for the detailed design, tendering and construction of Berford Street, from George Street to Elm Street.
Planned improvements include:
- Replacement of underground watermain, sanitary sewer, and storm sewer infrastructure
- Full road reconstruction, including new pavement
- Installation of new sidewalks to enhance pedestrian safety and accessibility
- Upgraded streetlighting, as well as the traffic signal system at the Frank Street intersection
Funding
This project is supported in part through the Ontario Connecting Links program, which provides provincial funding for municipal roadway corridors that connect provincial highways through communities.
In 2019, the Town of South Bruce Peninsula retained R.J. Burnside & Associates Limited to provide detailed engineering design, project management, and construction administration services for the future replacement of watermain, sanitary sewer, storm sewer, and the required road reconstruction of several roads in the Wiarton settlement area.
Berford Street Reconstruction - Phase I
Phase I of the Berford Street reconstruction - Division Street south to George Street - was completed between 2019 and 2023. This phase included the design and reconstruction of underground infrastructure, and the roadway, forming a key first step in overall improvements.
Current Project Phase
Funding has been allocated in the Town's 2025 and 2026 Capital Budgets for the detailed design, tendering and construction of Berford Street, from George Street to Elm Street.
Planned improvements include:
- Replacement of underground watermain, sanitary sewer, and storm sewer infrastructure
- Full road reconstruction, including new pavement
- Installation of new sidewalks to enhance pedestrian safety and accessibility
- Upgraded streetlighting, as well as the traffic signal system at the Frank Street intersection
Funding
This project is supported in part through the Ontario Connecting Links program, which provides provincial funding for municipal roadway corridors that connect provincial highways through communities.
-
Designated Detour Routes
Share Designated Detour Routes on Facebook Share Designated Detour Routes on X (formerly Twitter) Share Designated Detour Routes on Linkedin Email Designated Detour Routes link

Starting Wednesday, July 1, 2026, Berford Street will be closed to through traffic between Elm Street and Frank Street for construction.
The closure is expected to remain in place until at least Labour Day.The road will be open to local traffic and emergency vehicles only. Local traffic is for residents only. Business access will remain available via Frank Street.
Please use the following designated detour routes:
Northbound
D1 - Trucks/RVs via Boat Lake Road

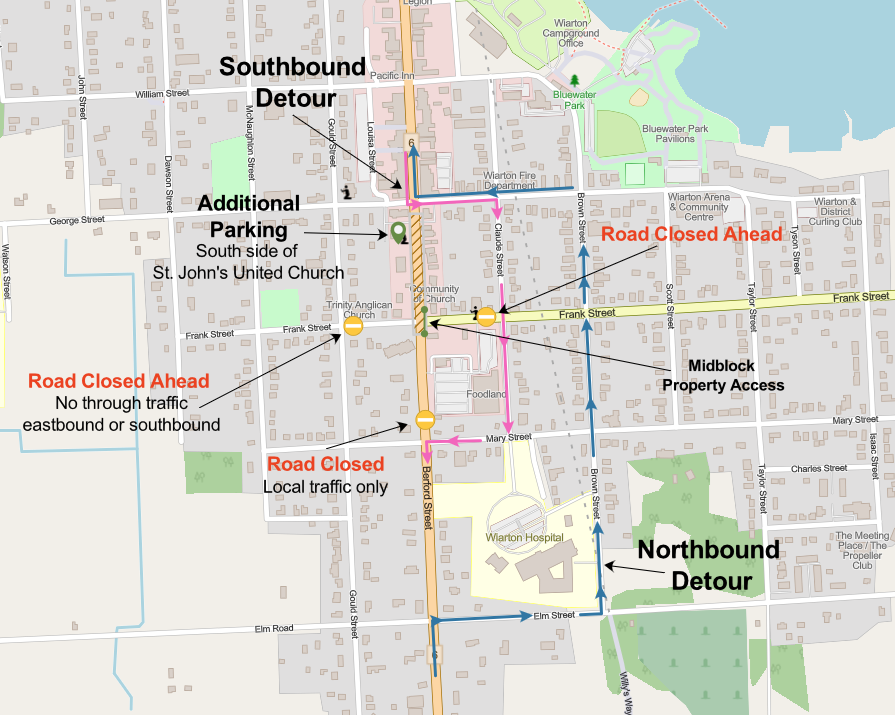

D2 - Cars/Downtown via Elm StreetSouthbound
D3 - Trucks/RVs via Bruce Road 13/Jenny Street
D4 - Cars to Highway 6 south via Gould Street
D5 - Cars through Downtown to Highway 6 Southđź“…Construction is expected to continue from Frank Street to George Street after Labour Day. Additional details and updated traffic information will be shared at a later time.
For project updates, visit:
📍 municipal511.caThank you for your patience and cooperation as we complete these necessary improvements!
Starting Wednesday, July 1, 2026, Berford Street will be closed to through traffic between Elm Street and Frank Street for construction.
The closure is expected to remain in place until at least Labour Day.The road will be open to local traffic and emergency vehicles only. Local traffic is for residents only. Business access will remain available via Frank Street.
Please use the following designated detour routes:
Northbound
D1 - Trucks/RVs via Boat Lake Road
D2 - Cars/Downtown via Elm StreetSouthbound
D3 - Trucks/RVs via Bruce Road 13/Jenny Street
D4 - Cars to Highway 6 south via Gould Street
D5 - Cars through Downtown to Highway 6 Southđź“…Construction is expected to continue from Frank Street to George Street after Labour Day. Additional details and updated traffic information will be shared at a later time.
For project updates, visit:
📍 municipal511.caThank you for your patience and cooperation as we complete these necessary improvements!
-
Construction Update: Notice to Residents
Share Construction Update: Notice to Residents on Facebook Share Construction Update: Notice to Residents on X (formerly Twitter) Share Construction Update: Notice to Residents on Linkedin Email Construction Update: Notice to Residents link
Construction is set to begin in late June 2026 and is expected to be completed by December 2026.
To help residents and visitors plan ahead, here are a few important details:
đźš§ Road Closure in Effect
- Berford Street from Elm Street to Frank Street is closed and will remain closed until September 2026.
- The Frank Street intersection will remain open to accommodate detour traffic.
đź“… Future Closure
- Berford Street from Frank Street to George Street will remain open until September 2026.
- More information about this upcoming closure will be shared as details become available.
đź•’ Construction Hours
- Work will typically take place Monday through Friday from 7:00 a.m. to 7:00 p.m.
- Saturday work may occur when required.
📨 Stay Informed!
- Weekly email updates are available throughout the project.
- Check the Notice to Residents for information on how to join the mailing list.
The Notice to Residents is available in the Documents section. We encourage you to review it and stay informed as the project progresses.
Construction is set to begin in late June 2026 and is expected to be completed by December 2026.
To help residents and visitors plan ahead, here are a few important details:
đźš§ Road Closure in Effect
- Berford Street from Elm Street to Frank Street is closed and will remain closed until September 2026.
- The Frank Street intersection will remain open to accommodate detour traffic.
đź“… Future Closure
- Berford Street from Frank Street to George Street will remain open until September 2026.
- More information about this upcoming closure will be shared as details become available.
đź•’ Construction Hours
- Work will typically take place Monday through Friday from 7:00 a.m. to 7:00 p.m.
- Saturday work may occur when required.
📨 Stay Informed!
- Weekly email updates are available throughout the project.
- Check the Notice to Residents for information on how to join the mailing list.
The Notice to Residents is available in the Documents section. We encourage you to review it and stay informed as the project progresses.
-
Stay Informed!
Share Stay Informed! on Facebook Share Stay Informed! on X (formerly Twitter) Share Stay Informed! on Linkedin Email Stay Informed! link
We encourage you to stay informed as the project moves forward. If you are directly affected - own property on Berford Street between George Street and Elm Street, or adjacent to Berford Street along Frank Street or Mary Street - you can fill out the form (under Documents) or contact Kiersten Thompson, Public Works Administrative Assistant, by email to kiersten.thompson@southbrucepeninsula.com or by phone at (519) 534-1400 ext. 138, to share your details.
Once you're signed up, you will receive regular email updates - typically on a weekly basis - with information on project milestones, upcoming construction activities, and important notices.
Your contact information will be kept confidential and used only to share updates about this project.
We encourage you to stay informed as the project moves forward. If you are directly affected - own property on Berford Street between George Street and Elm Street, or adjacent to Berford Street along Frank Street or Mary Street - you can fill out the form (under Documents) or contact Kiersten Thompson, Public Works Administrative Assistant, by email to kiersten.thompson@southbrucepeninsula.com or by phone at (519) 534-1400 ext. 138, to share your details.
Once you're signed up, you will receive regular email updates - typically on a weekly basis - with information on project milestones, upcoming construction activities, and important notices.
Your contact information will be kept confidential and used only to share updates about this project.
-
From the Design Open House
Share From the Design Open House on Facebook Share From the Design Open House on X (formerly Twitter) Share From the Design Open House on Linkedin Email From the Design Open House link
Following the Design Open House held on April 7, we’re sharing the materials that were presented and discussed with attendees. The uploaded documents include the presentation slides and engineering and streetscape drawings, so all community members can access the same information shared at the event.
If you weren’t able to attend, we encourage you to review the presentation to stay informed.
If you have any comments or feedback after your review, please feel free to complete the Comment Sheet (available under Documents) and return it to one of the project team members listed on the form.
Thank you to everyone who attended and shared their feedback—we appreciate the input!
Following the Design Open House held on April 7, we’re sharing the materials that were presented and discussed with attendees. The uploaded documents include the presentation slides and engineering and streetscape drawings, so all community members can access the same information shared at the event.
If you weren’t able to attend, we encourage you to review the presentation to stay informed.
If you have any comments or feedback after your review, please feel free to complete the Comment Sheet (available under Documents) and return it to one of the project team members listed on the form.
Thank you to everyone who attended and shared their feedback—we appreciate the input!
-
Notice of Design Open House
Share Notice of Design Open House on Facebook Share Notice of Design Open House on X (formerly Twitter) Share Notice of Design Open House on Linkedin Email Notice of Design Open House link
The Town, in conjunction with R.J. Burnside & Associates Limited (engineering consultant), will be hosting a Design Open House on Tuesday, April 7, 2026, for the Berford Street Reconstruction – Phase II project.
A copy of the Notice of Design Open House is available on the Town’s Open Mic page under “Documents” and “Key Dates”.
The Town, in conjunction with R.J. Burnside & Associates Limited (engineering consultant), will be hosting a Design Open House on Tuesday, April 7, 2026, for the Berford Street Reconstruction – Phase II project.
A copy of the Notice of Design Open House is available on the Town’s Open Mic page under “Documents” and “Key Dates”.
Who's Listening
-
SL
Phone 226-568-0055 Email sandra.ccc.pr@gmail.com -
JS
Phone 519-270-4291 Email jstmarie@clearwatershores.ca -
KW
Phone 519-270-2837 Email kwelsh@clearwatershores.ca -
BC
Phone 519-534-1400 x 131 Email brianna.collins@southbrucepeninsula.com
